/*! This file is auto-generated */ .wp-block-button__link{color:#fff;background-color:#32373c;border-radius:9999px;box-shadow:none;text-decoration:none;padding:calc(.667em + 2px) calc(1.333em + 2px);font-size:1.125em}.wp-block-file__button{background:#32373c;color:#fff;text-decoration:none} Q8OQ. Plan production for a four-month... [FREE SOLUTION] | 91Ó°ÊÓ

91Ó°ÊÓ

Plan production for a four-month period: February through May. For February and March, you should produce to exact demand forecast. For April and May, you should use overtime and inventory with a stable workforce; stable means that the number of workers needed for March will be held constant through May. However, government constraints put a maximum of 5,000 hours of overtime labor per month in April and May (zero overtime in February and March). If demand exceeds supply, then backorders occur. There are 100 workers on January 31. You are given the following demand forecast: February, 80,000; March, 64,000; April, 100,000; May, 40,000. Productivity is four units per worker hour, eight hours per day, and 20 days per month. Assume zero inventory on February 1. Costs are hiring, \(50 per new worker; layoff, \)70 per worker laid off; inventory holding, \(10 per unit-month; straight-time labor, \)10 per hour; over time, \(15 per hour; backorder, \)20 per unit. Find the total cost of this plan.

Short Answer

Expert verified

The total cost of this plan is $1,318,000.

Step by step solution

01

Please refer to the following calculation

Employed = Maximum of (Number of laborers of this current month - Number of laborers for the earlier month, 0)

Terminated = Maximum of (Number of laborers of the earlier month - Number of laborers during the current month, 0)

Normal Production = Number of laborers x 8 (hours/day) x 20 (days/month) x 4 (units/hour)

Since Regular Production < Demand in April,

Extra time creation in April = 5000 hours x 4 (hours/unit) = 20000 units

Complete Production = Regular Production + Overtime Production

Inventory for February = Total Production - Demand for February

Inventory for February = 0

Inventory for March = Inventory for February + Total Production for March - Demand for March

Inventory for March = 0

Since for April, Total Production < Demand, Inventory = 0

Delay purchase = Demand for April - Total Production for April

Inventory for May = Total Production for May - Demand for May

Complete Cost = Total Hired x 50 + Total Fired x 70 + Total Regular Production x 10 ($/hour)/4 (units/hour) + Total Overtime Production x 10 ($/hour)/4 (units/hour) + Total Inventory x 10 + Total Backorder x 20

02

Calculations

Unlock Step-by-Step Solutions & Ace Your Exams!

  • Full Textbook Solutions

    Get detailed explanations and key concepts

  • Unlimited Al creation

    Al flashcards, explanations, exams and more...

  • Ads-free access

    To over 500 millions flashcards

  • Money-back guarantee

    We refund you if you fail your exam.

Over 30 million students worldwide already upgrade their learning with 91Ó°ÊÓ!

One App. One Place for Learning.

All the tools & learning materials you need for study success - in one app.

Get started for free

Most popular questions from this chapter

Question: After using your forecasting model for six months, you decide to test it using MAD and a tracking signal. Here are the forecast and actual demands for the six months;

Period

Forecast

Actual

May

450

500

June

500

550

July

550

400

August

600

500

September

650

675

October

700

600

a. Find the tracking signal.

b. Decide whether your forecasting routine is acceptable.

Daily demand for a certain product is normally distributed with a mean of 100 and a standard deviation of 15. The supplier is reliable and maintains a constant lead time of 5 days. The cost of placing an order is \(10 and the cost of holding inventory is \)0.50 per unit per year. There are no stockout costs, and unfilled orders are filled as soon as the order arrives. Assume sales occur over 360 days of the year. Your goal here is to find the order quantity and reorder point to satisfy a 90 percent probability of not stocking out during the lead time.

a. What type of system is the company using?

b. Find the order quantity.

c. Find the reorder point.

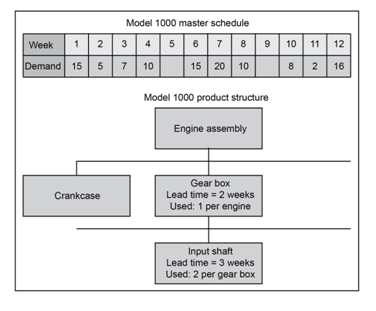

Initially, assume that Phil wants to minimize his inventory requirements. Assume that each order will be only for what is required for a single period. Using the following forms, calculate the net requirements and planned order releases for the gear boxes and input shafts. Assume that lot sizing is done using lot-for-lot (L4L)
