/*! This file is auto-generated */ .wp-block-button__link{color:#fff;background-color:#32373c;border-radius:9999px;box-shadow:none;text-decoration:none;padding:calc(.667em + 2px) calc(1.333em + 2px);font-size:1.125em}.wp-block-file__button{background:#32373c;color:#fff;text-decoration:none} Q4-5OQ-a The following activities are par... [FREE SOLUTION] | 91Ó°ÊÓ

91Ó°ÊÓ

The following activities are part of a project to be scheduled using CPM:

Activity

Immediate Predecessor

Time (Weeks)

A

_

6

B

A

3

C

A

7

D

C

2

E

B,D

4

F

D

3

G

E,F

7

Short Answer

Expert verified

The critical path method (CPM) is a strategy for identifying activities required for project finish as well as determining schedule flexibility.

Step by step solution

01

Draw the data given below

The followingdatais provided

Activity

Immediate Predecessor

Time (Weeks)

A

_

6

B

A

3

C

A

7

D

C

2

E

B,D

4

F

D

3

G

E,F

7

02

Draw a network diagram

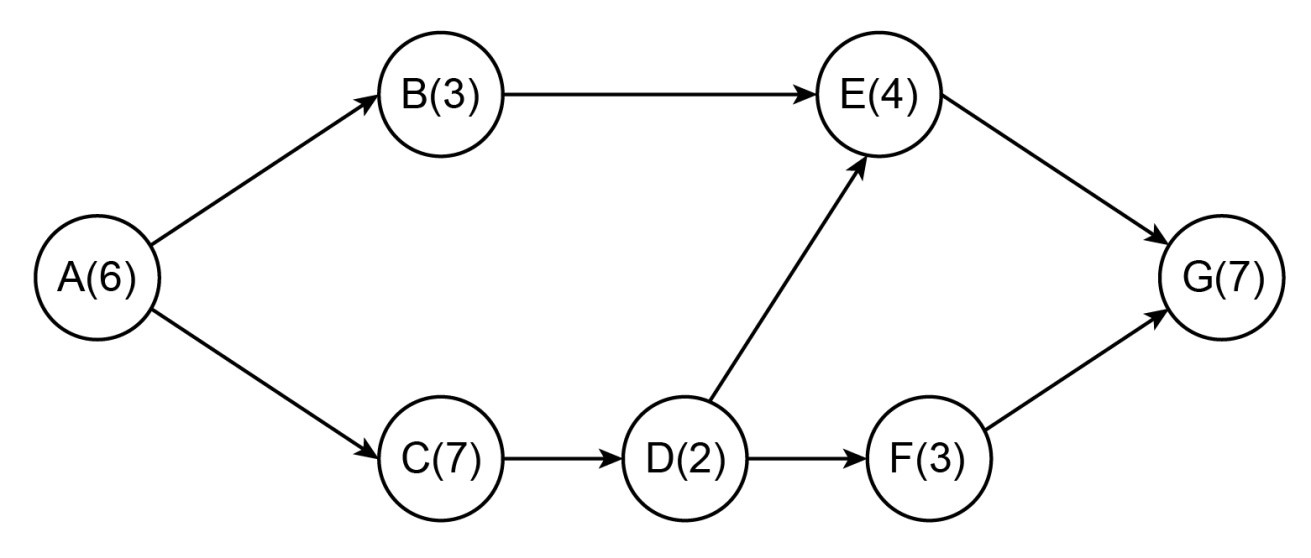

The network diagram is shown below

Unlock Step-by-Step Solutions & Ace Your Exams!

  • Full Textbook Solutions

    Get detailed explanations and key concepts

  • Unlimited Al creation

    Al flashcards, explanations, exams and more...

  • Ads-free access

    To over 500 millions flashcards

  • Money-back guarantee

    We refund you if you fail your exam.

Over 30 million students worldwide already upgrade their learning with 91Ó°ÊÓ!

One App. One Place for Learning.

All the tools & learning materials you need for study success - in one app.

Get started for free

Most popular questions from this chapter

This defines the hierarchy of project tasks, subtasks, and work packages.

Question: What are the three elements that require integration to be successful in operations and supply chain management?

What are additional features of the IKEA concept (beyond its design process) that contribute to creating exceptional value for the customer?

A builder has located a piece of property that she would like to buy and eventually build on. The land is currently zoned for four homes per acre, but she is planning to request new zoning. What she builds depends on the approval of zoning requests and your analysis of this problem to advise her. With her input and your help, the decision process has been reduced to the following costs, alternatives, and probabilities:

Cost of land: \(2 million.

Probability of rezoning: 60.

If the land is rezoned, there will be additional costs for new roads, lighting, and so on, of \)1 million. If the land is rezoned, the contractor must decide whether to build a shopping center or1, 500 apartments that the tentative plan shows would be possible. If she builds a shopping center, there is a 70 percent chance that she can sell the shopping center to a large department store chain for \(4 million over her construction cost, which excludes the land; and there is a 30 percent chance that she can sell it to an insurance company for \)5 million over her construction cost (also excluding the land). If instead of the shopping center, she decides to build the 1,500 apartments, she places probabilities on the profits as follows:

There is a 60 percent chance that she can sell the apartments to a real estate investment corporation for \(3,000 each over her construction cost; there is a 40 percent chance that she can get only \)2,000 each over her construction cost. (Both exclude the land cost.)

If the land is not rezoned, she will comply with the existing zoning restrictions and simply build 600 homes, on which she expects to make $4,000 over the construction cost on each one (excluding the cost of land).

Draw a decision tree of the problem and determine the best solution and the expected net profit.

Jack Simpson, contract negotiator for Nebula Airframe Company, is currently involved in bidding on a follow-up government contract. In gathering cost data from the first three units, Nebula produced under a research and development contract, he found that the first unit took 2,000 labor hours, the second took 1,800 labor hours, and the third took 1,692 hours.In a contract for three more units, how many labor hours should Simpson plan for?

See all solutions

Recommended explanations on Business Studies Textbooks

View all explanations

What do you think about this solution?

We value your feedback to improve our textbook solutions.

Study anywhere. Anytime. Across all devices.
